High and Dry at Last

(Wilton, CT)

Imagine buying a home with a beautiful brook in the backyard. Now imagine that same brook causing your partially below grade playroom and garage to flood in heavy rains, a “phantom menace” that comes and goes and so quickly, most often at night, so that you hardly ever actually see it in daylight.

Other firms suggested raising the whole house, an extremely costly proposition.

We channeled the clients' money differently - developing a solution that involved closing off water access points and building a new garage slightly above the flood plain, then adding a new mud room entry and a master suite addition to top it all off. The additions blend seamlessly with the home's original architecture.

It's hard to imagine the volume of water that appeared and the extent of the water problem, but here are a few shots that help to tell that story.

 Here's the stream. Actually it's the Silvermine River, part of the Norwalk River Watershed.

It wasn't unusual for the water level to rise eight feet or more for a short time during storms.

High water in Silvermine river, Wilton, CT

The good news was that when this happened, the stream rose suddenly and then quickly subsided.

Another view of the Silvermine River.

During these surges, the water typically totally flooded the backyard. Here's the swingset as seen from the porch. No place to play unless you like to swim.

Submerged swingset in backyard.

The same view, from the porch, on a normal day.

Sunny day in the beautiful backyard

The fact that the driveway sloped towards the house compounded the flood situation.

Driveway slopes towards the garage before addition is added

Here's a shot the driveway, during one of the flood periods.

Driveway while flooding is underway.

Turning around to look at the garage you can see that not only couldn't you park your car in the garage, but the basement totally filled as well.

Heroic efforts were made to keep the water out, such as plasticing up the garage doors and putting up interior barricades, although it's almost impossible to stop water going where it wants to go.

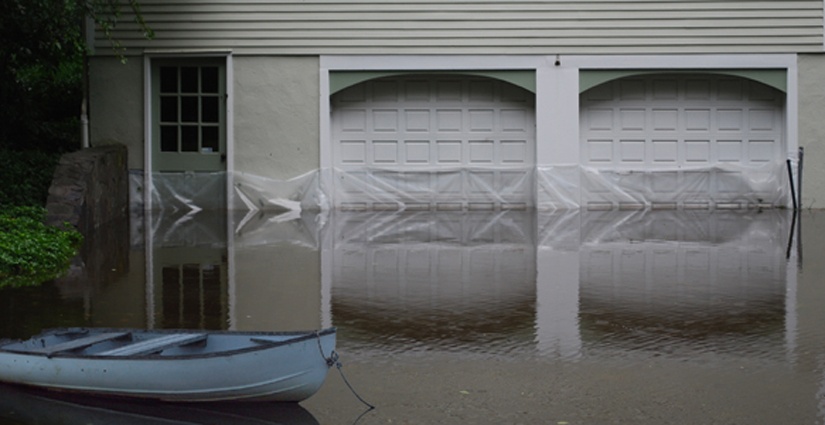

Flooded driveway with blue boat

Here's a couple shots of the home on a dry sunny day.

After flooding receded, here is the garage on a sunny day.
a view of the house from the back, after the river has receeded

As we began the design process we discovered a lot of constraints on what was permissible. The Conservation Commission would not allow regrading around the house because of a concern that this would displace water downstream, which limited some of the options.

The plan that made the most sense was to close off all current points of water access into the house (garage doors, man door, back door under the porch) and then build an addition in the gully between the upper part of the driveway and the original garage.

This would gave our clients a structure at a higher elevation, with any doors a few inches above the flood plain. This would ensure that water would not invade the home during normal storm surges.

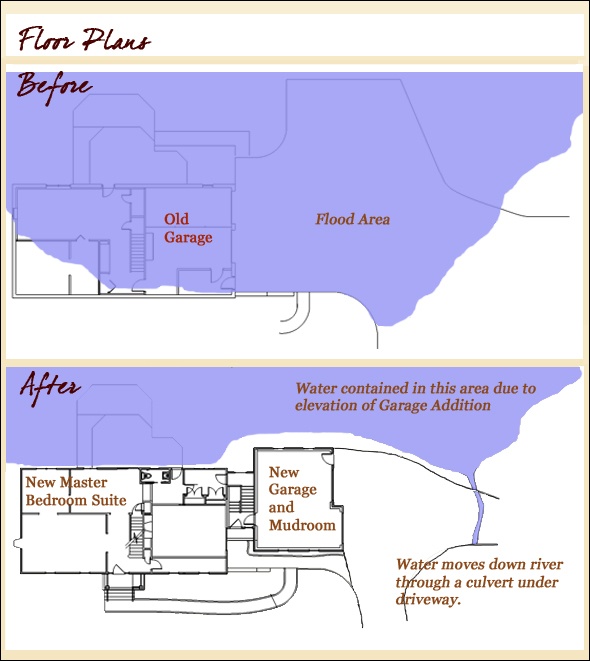

Floor plan shows changes of elevation to ensure flood water would not enter home.

Here you can see visually how the water elevation changed as a result of the work. Positioning the addition in this way allowed us to keep the water back away from the house without regrading the yard.

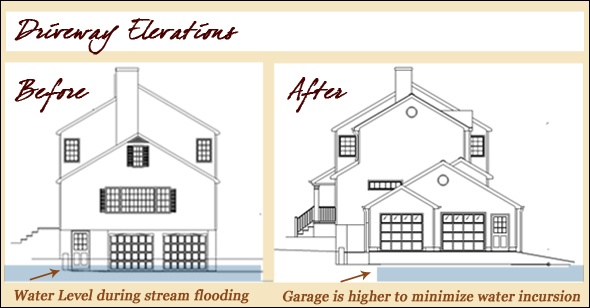

Driveway elevations change in these before and after drawings

Similarly, at the back, the water was kept further away, because the garage is two feet higher than it was.

back elevations before and after the home improvements show the differing water heights

Our clients also wanted a master bedroom suite. Due to health code limiting the number of bedrooms, based upon septic tank size, it was desirable to maintain the same number of bedrooms while adding on. In order to do so, we "un-bedroomed" one of the old bedrooms, turning it into an open office and/or homework area.

This allowed us to add a master bedroom to the home while remaining within health department limits for "number of bedrooms" based on their existing tank, avoiding any septic costs.

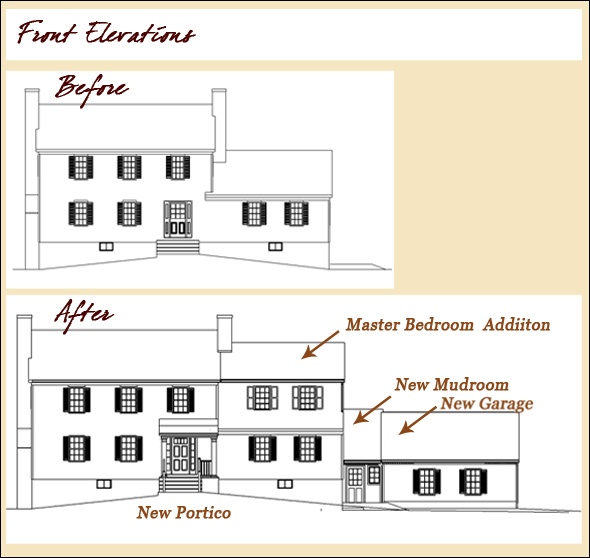

Front elevations showing the new portico and additions

This door at the end of the hallway leads to an existing storage room over the family room.

On the left side of the hall at the top of the stairs is where we will be cutting the existing bedroom wall down. By opening up the door and creating a knee wall, the former bedroom will no longer considered as such.

This works well for our clients, who are happy to have this repurposed space.

hallway before the renovations

The existing storage room is the perfect place to create the new master suite.

It's positioned to take advantage of backyard views, with easy access to the other bedrooms, as well as the stairs to the first floor.

storage room

The existing oversized family will be converted into a smaller family room with a new mud room and a relocated powder room.

oversized family room before renovations
Here's the "Before" of the front of the house. A portico will be added and the front stoop modified to jazz up the front facade.
front elevation of the house before the portico and stoop are added to add curb appeal

Construction Begins

The first step in stopping water infiltration was to close up this playroom door and the door under the porch in order to alleviate the water problem before refinishing the interior.

playroom door is closed up

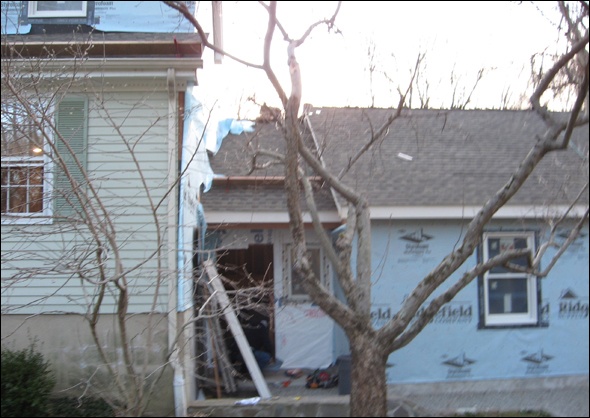

This exterior shot shows the opening to the former playroom after it was closed up.

Closed up playroom door shown from the exterior

Just inside the closed up opening is the basement. We finished off this room in advance of the major construction so that the clients could use it for storage while we completed the remainder of the project.

The first step of the refinishing project was to replace the the former flood-damaged sheetrock and insulation.

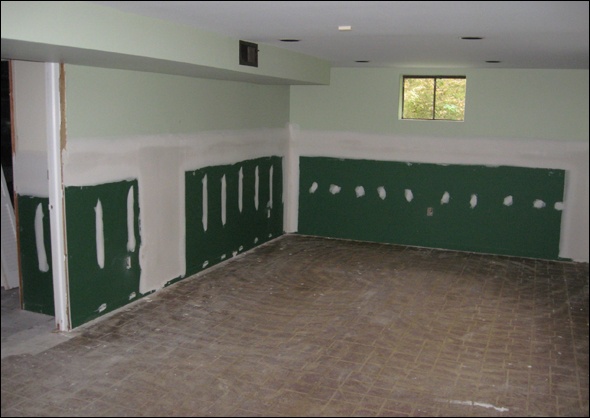

Basement walls have been sheetrocked

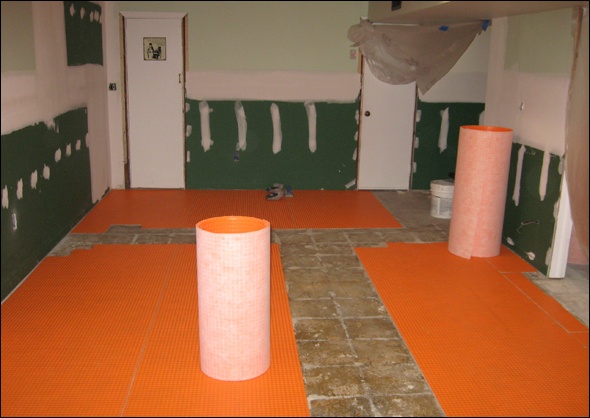

A special underlayment, Ditramat, was used on the cement before tiling to preclude tile cracking. We often use this material under large tiles, as it provides a superior, long lasting, final product.

Clark Construction has used Ditramat on the basement floor to provide a solid base for the large tiles

Here is a closeup of the finished product, showing a subtle pattern created by alternating the direction of the tile.

Alternating tile shows a subtle textural pattern.

While installing the basement tile floor, the outside was being prepared for the addition portion of the project to start.

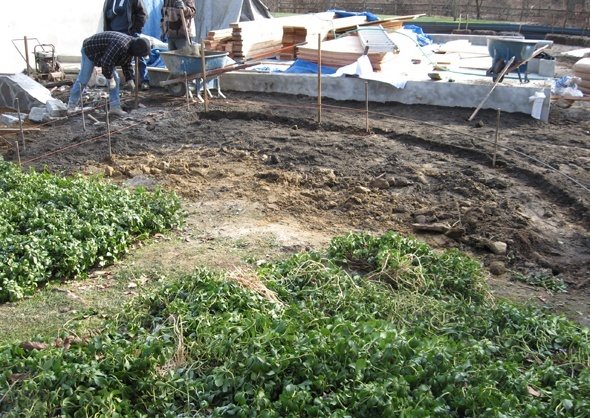

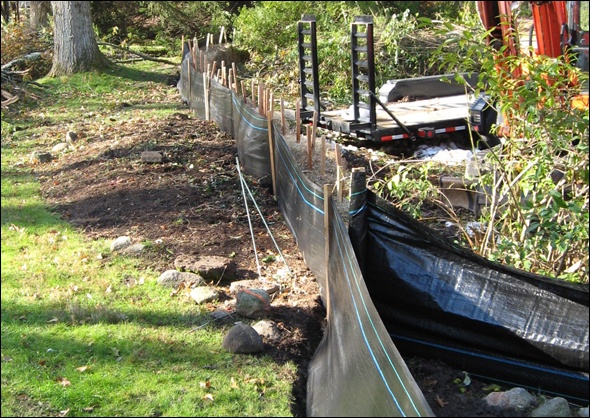

Silt fencing and hay bales were laid out to protect the wetland environment during construction.

Silt fence and hay bales protect the wetlands from the construction project

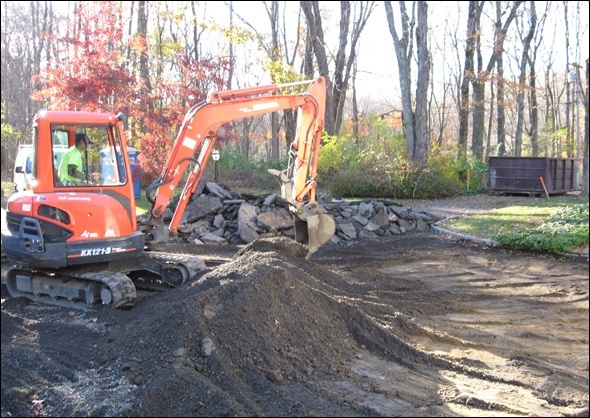

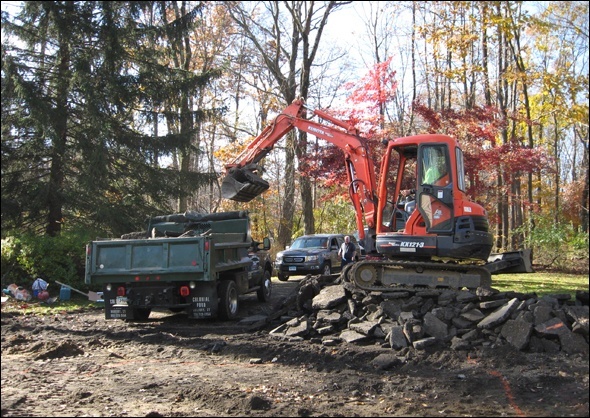

Necessary excavation began with removal of the asphalt driveway.
Excavator removes the asphalt driveway

The old driveway was loaded into dump trucks and taken to a recycling center.

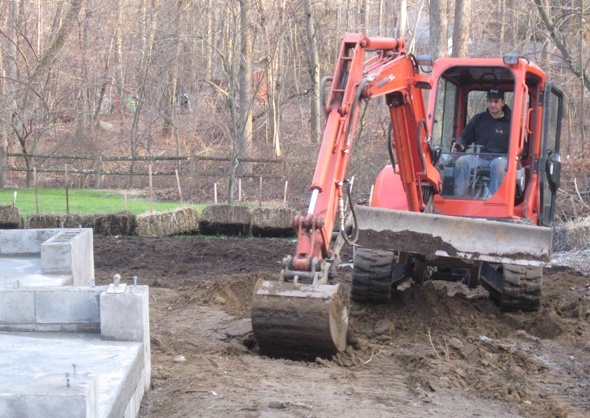

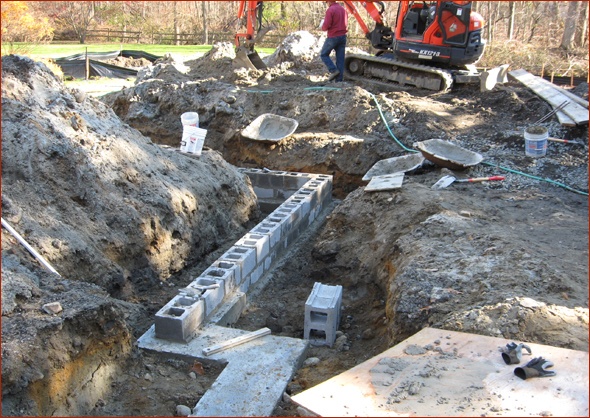

What looks like a moat is actually a trench for the new garage footings.

Because it was below the water table, the trench was filling with ground water so quickly that we had to pump continuously in order to get it dry enough to be able to pour concrete.

trench for the new garage footings

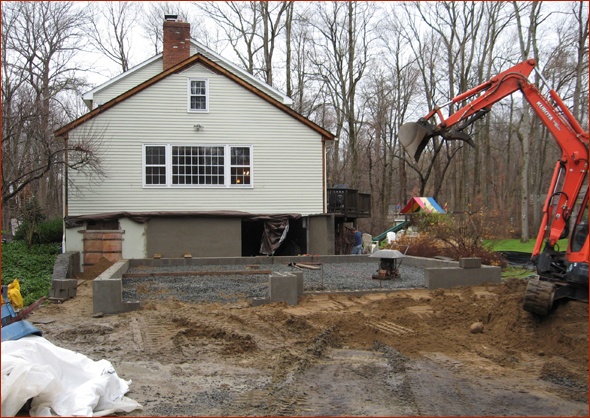

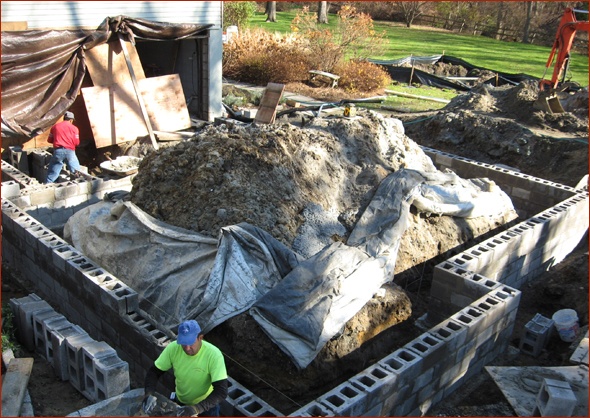

The footings were formed and poured, allowing the new garage to take shape.

footings are formed and poured
The first course of block was laid over the cured foundation.
The foundation begins with one course of block.

The masons continued to work on finishing the foundation.

Work continues on the foundation

In the distance, you can see the former garage doors being closed up.

The foundation for the garage is complete

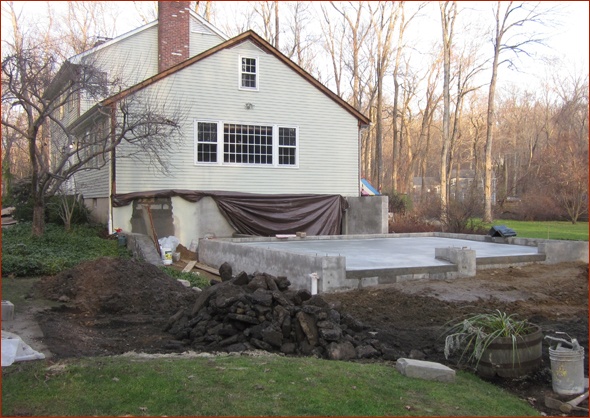

With the slab complete, it almost looks so flat you could skate on it!

garage slab has been poured

Backfilling was done next.

We brought in several truckloads of fill for use under the addition, but due to Wetlands requirements, the surrounding area had to be reshaped to its existing condition.

backfilling is being done for the addition

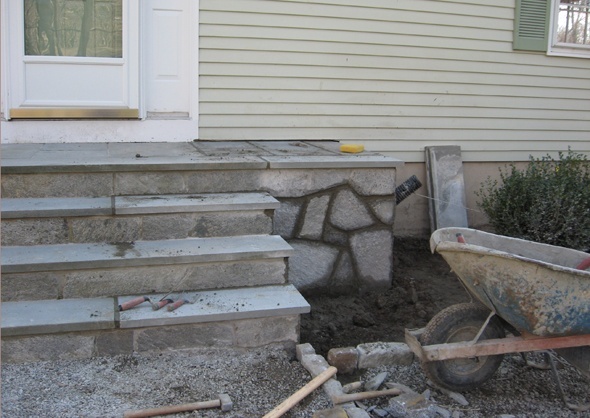

The masons extended the stoop, adding flagstone and a stone veneer.

stoop has been extended

The sidewalk was reconfigured at the new grade, saving as many of the original plantings as possible.

sidewalk is repositioned, and plantings retained

This view gives you an idea of how much higher the new garage, (on the right), will sit relative to the old garage, seen here on the left

The next step was to frame the master bedroom addition.

As the plan was to raise the roof, we stripped the former storage room roof down to the joists, and then cut them back where the roof was to be raised, as you can see in the next photo.

Framing the master bedroom addition begins.

The demolition continued with the removal of the family room picture window and balance of the roof framing.

Family room picture window has been removed

Here you can see the new master bedroom suite is taking shape.

Master bedroom suite in Wilton CT takes shape.

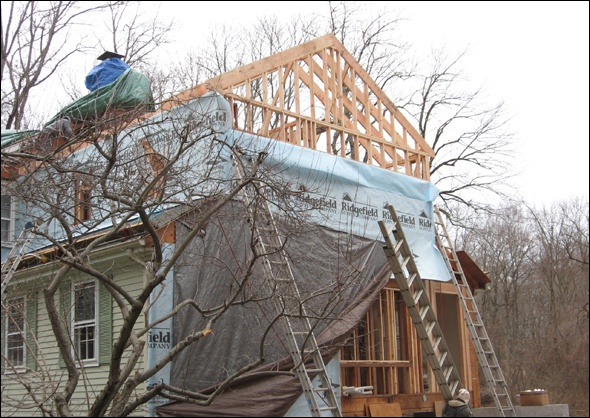

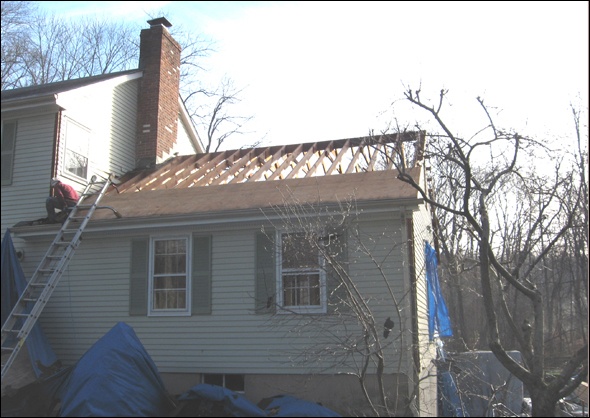

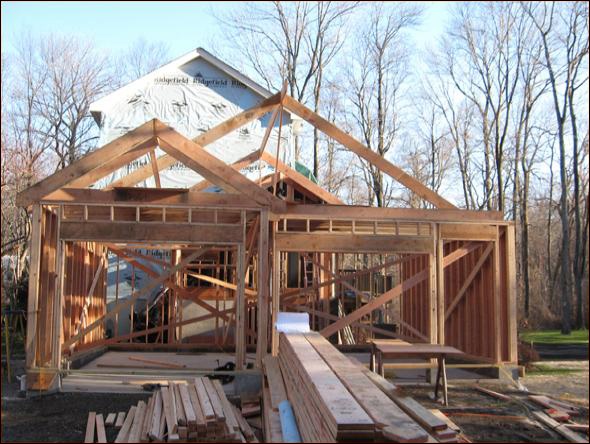

As the master bedroom roof was framed the addition started to mimic the rooflines of the original house.

Clark Construction's master bedroom suite addition is framed

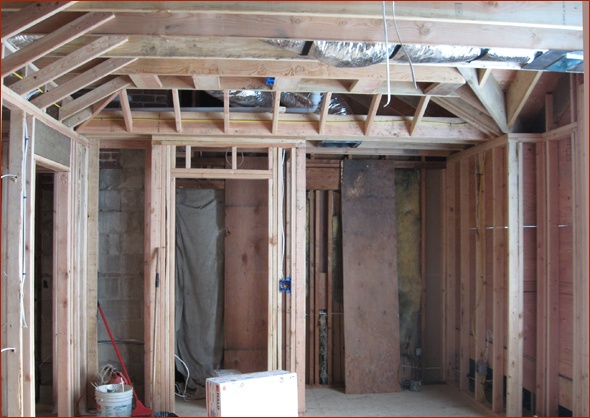

The shape of the master bedroom’s tray ceiling can be seen in the framing.

Framing of the master bedroom tray ceiling

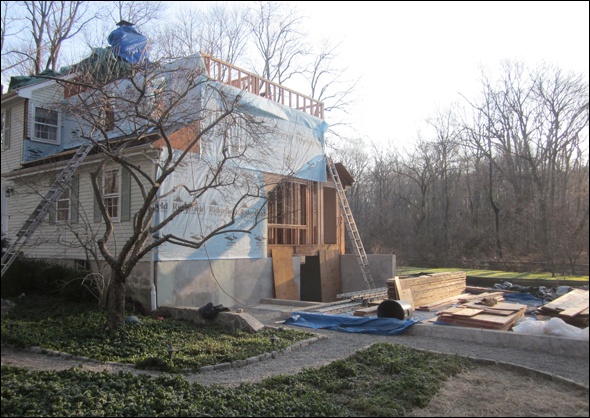

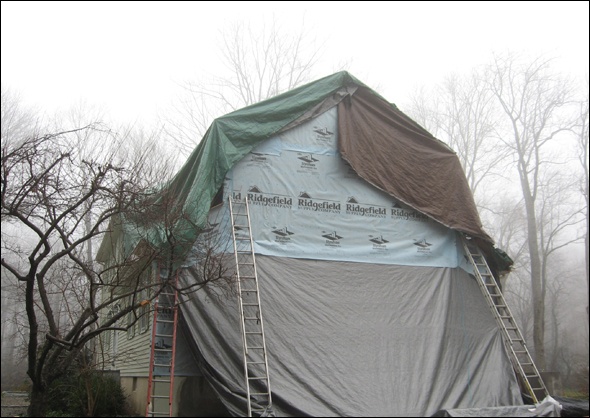

Oversized tarps kept the cold winter rains out of the home while work continued inside.

Oversized tarps cover the addition during construction.

With the roof on the master suite complete and the home buttoned up tight with a moisture barrier, framing of the garage could begin.

Master bedroom suite with roof completed and moisture barrier on the outside.

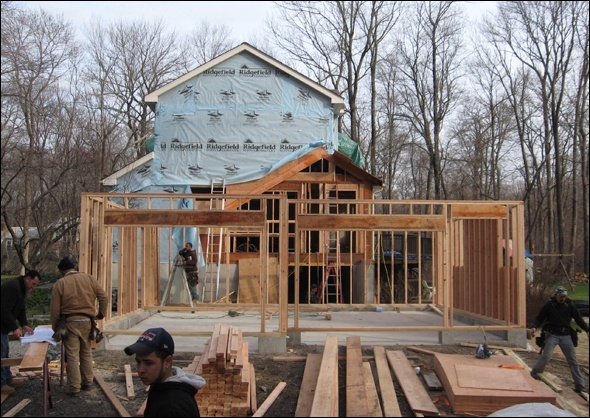

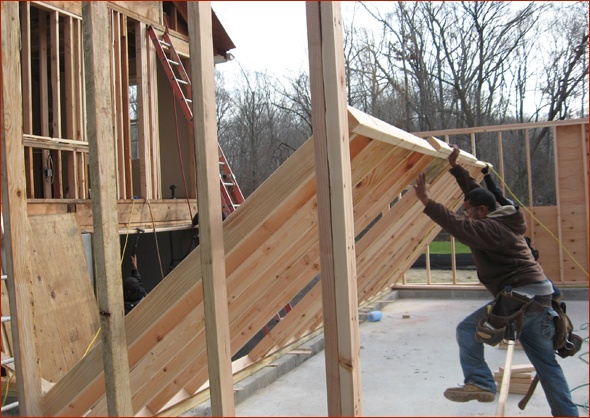

To speed the framing process, walls were constructed in their entirety on the floor and then raised into place.

Walls are raised during this home improvement project.

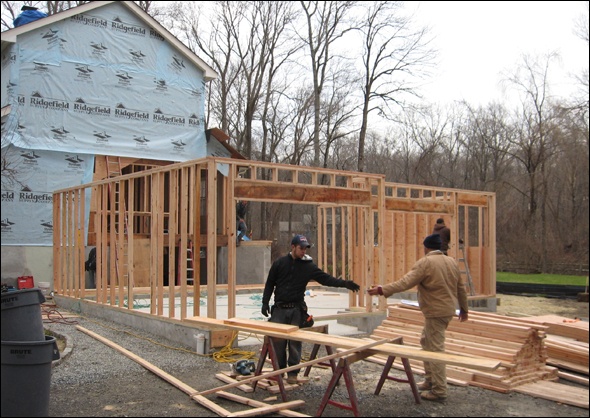

With the walls up, the oversized garage is really starting to take shape.

Oversized garage takes shape.

Repeating the original gable rooflines made for a seamless addition.

Addition design calls for repeating gables on the garage
The new mud entry attaches the new garage to the house.
new mud room entry
Now everything's buttoned up, ready for exterior trim and siding.
Addition is ready for exterior trim and siding
Advanced planning of the addition's location allowed this tree in the front yard to be saved.
Tree which was saved in the front yard.
Looking down from the upper landing you can see the newly installed mud entry door.
New mud entry door viewed from above

Here you can see sheetrock being installed on the family room ceiling.

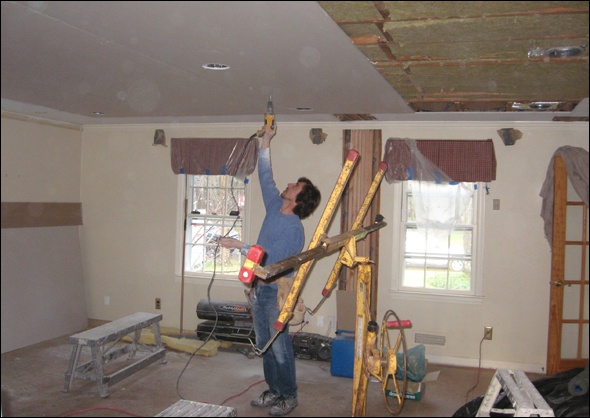

A hand crank sheetrock lift that was used to raise the large pieces of sheetrock into position, faciliating their manipulation and speeding up the process.

Sheetrock on the family room ceiling.

Oak floors were laid in the new master bedroom, family room and mudroom.

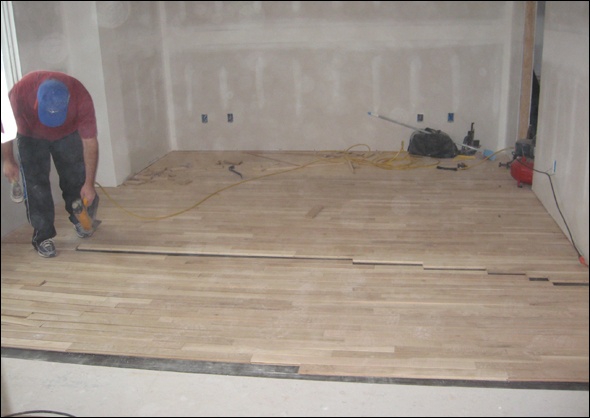

oak floor  installation in the master bedroom

On the left you can see the existing guest bedroom wall which was cut down.

If you look past this new office area, you can see into the new master bedroom suite, which was converted from the storage room.

These areas are trimmed and ready for paint.

half wall at the former guest bedroom

A beautiful furniture style double vanity is the star of the new bathroom.

dark stain bath cabinetry in master bath design

Creative tile layouts helped break up an over-sized shower.

Once the shower tile was completed we were able to template for the frameless glass shower enclosure.

Oversized shower with interesting tile layout

While trim is being completed through out the house, finishing touches such as the newel posts and banister for the mudroom entry could be installed.
newel posts and banister in the mudroom entry

Interior and exterior work ran concurrently. Siding and trim were installed as the project neared completion.
partially completed siding on garage
New garage doors and openers were installed. These newer doors offer superior insulation and quieter operation than their older counterparts.

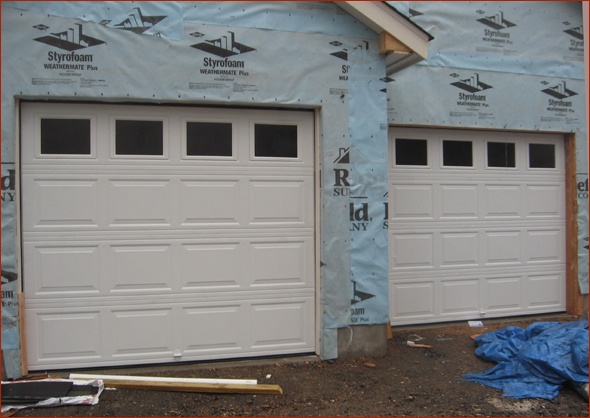

New garage doors installed
Ladder jacks and scaffolding made it possible to do the siding on the back of the house with ease.

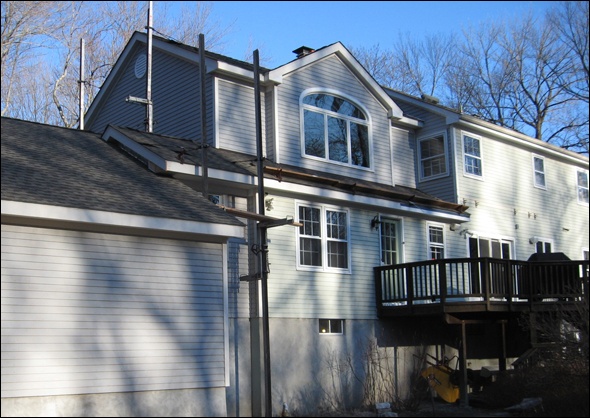

Siding is installed on the back of the house using ladder jacks and scaffolding

The new portico was constructed and trimmed out.
New portico on the front of this Wilton CT home.
Square columns and maintenance free railing materials were installed to finish it off.
square columns and maintenance free railings

An added benefit of opening up the wall at the new office was bringing natural light into a previously dark second floor hall.

opening the wall to the office

Here you can see the view into the master bedroom suite after it was painted and ready for move in.

master bedroom can be seen down the hallway
The placement of this window opposite the bed wall ensures opening your eyes to a beautiful view each morning.
Beautiful arched top window
The completed shower offers an abundance of glass to provide natural light and a view through nearby windows.
Completed shower has a lot of glass panels
The vanity is topped with honed marble, which elegantly contrasts its dark finish.
Vanity with honed marble top.
Here you can see the completed mud entry finished with warm bright colors, inviting you into the home.
Mud room entry completed in warm bright colors
Continuous oak flooring in the powder room, family room and the mudroom make these spaces flow smoothly together.
Oak flooring flows smoothly through three rooms
Here's the mud room we keep mentioning, completed.
Clark Construction's completed mud room in Fairfield County
The finished master bedroom shows how the tray ceiling adds height and drama to the space.
Finished master bedroom with tray ceiling in Wilton, CT
A small niche behind the master bedroom door made the perfect place to add some book shelves.
Bookshelves behind the master bedroom door

Here are some completed shots of the master bedroom suite, after painting.

From the back, you can see the new master bedroom suite atop the family room, with the garage to the left.

Clark Construction's completed master bedroom addition in Wilton CT viewed from the back

Here you can see the completed addition and garage with a gravel walkway to the mud entry door.

Note the horizontal window in the family room where the client's children can peek out and see who's coming down the driveway.

Completed addition and garage, viewed from the front of the home

In this view of the completed front you can see how the new roof lines work seamlessly with the old.

New roof lines work seamlessly with the existing home in Wilton, CT

And last but not least, the front entry is completed and ready to welcome friends and family into their newly updated and water tight home.

Front entry on New England colonial.
Team Something
Craftsmen

"We have done three projects with Clark Construction in the last five years and continue to be thrilled with the results. The common thread through all of the projects has been the detail of project planning and design, the quality of the work, and the ability to stay right on schedule."

Jeff P.
Wilton, CT

As a small company built on quality and accountability, we are easily accessible to discuss any concerns or questions you may have, before during and after the job. It's a level of service you can count on.
